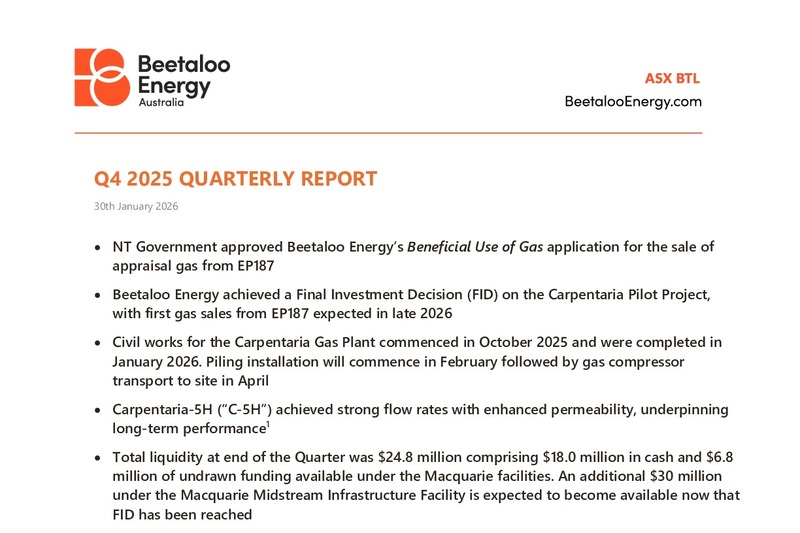

Beetaloo Energy Australia LimitedASX: BTL

Quarterly Activities Report - 31 December

· Issued by Beetaloo Energy Australia Limited

Filed with ASX · · 11 pages · English

• Civil works for the Carpentaria Gas Plant commenced in October 2025 and were completed in January 2026. Piling installation will commence in February followed by gas compressor transport to site in April • Carpentaria-5H (“C-5H”) achieved strong flow rates with enhanced permeability, underpinning long-term performance1 • Total liquidity at end of the Quarter was $24.8 million comprising $18.0 mi
