17 July 2025
SolGold plc
("SolGold" or the "Company")
Releases Execution Plan
· Project Execution Plan Completed & Approved
· G Mining Services Engineering Team prepares for early works mobilisation
· Independent Geotechnical Assessments confirm no fatal flaws for on-concession tailings storage sites
· ExploreCo Defined: The Company's highly prospective southern concessions to be put in a separate company, creating a NorthCo (Cascabel + Concessions) and SouthCo (Porvenir + Concessions)
· Tandayama Ameríca drilling continues with another rig added in the coming week to accelerate finalization of the drilling and allow for assessment of the economics of any potential pit(s)
SolGold (LSE: SOLG) is pleased to provide an update on progress for its flagship Cascabel Copper-Gold Project ("Cascabel" or the "Project") in northern Ecuador. The Company is advancing early development activities, including securing project funding, drilling at Tandayama-Ameríca ("TAM"), and preparing for the commencement of long-lead construction works.
SolGold has outlined a clear, staged development pathway for the Cascabel Project, with first production scheduled to begin in 2028-positioning Cascabel as a cornerstone copper asset for Ecuador and a strategic contributor to the global energy transition. This marks the beginning of a multi-decade mine life, unlocking sustained value for stakeholders across generations. The optimised project schedule prioritizes near-term cash flow through the phased development of the TAM open pit and Alpala Sub-Level Cave ("SLC"). Construction of the processing plant and an on-concession tailings storage facility is expected to be completed by Q4 2028, enabling ore processing shortly thereafter.
Key enabling activities-including the relocation of the Santa Cecilia community, early works on surface infrastructure, and development of the Alpala portal and decline system-are expected to be completed over the next 24 months. These efforts are running in parallel with feasibility-stage engineering and permitting work and are designed to shorten the path to production and enhance project readiness.
Throughout these development efforts, sustainability, safety, and community benefit have remained at the forefront of SolGold's approach. SolGold is not only developing a world-class copper-gold project-it is building a legacy. The Company integrates ESG principles into every phase of its development strategy, from environmental protection and water management to health, safety, nature, and community partnerships. As always, SolGold remains focused on delivering long-term value for all stakeholders: shareholders, host communities, and the nation of Ecuador.
PROGRESS HIGHLIGHTS
· Initial ore will be sourced from the TAM open pit (targeted for January 2028), followed by underground ore from the Alpala SLC in Q4 2028.
· Construction of the processing plant and on-concession tailings storage facility is expected to conclude in Q4 2028, enabling ore processing shortly thereafter.
· All critical early works-including Santa Cecilia community relocation, surface preparation, and decline access-are expected to be completed within 24 months.
· The full-scale Alpala Block Cave, which underpins long-term production, is scheduled to deliver first ore by year-end 2031.
Dan Vujcic, Chief Executive Officer of SolGold, commented:
"We are now in execution mode - we have a plan that prioritizes momentum, risk management, and early returns. By fast-tracking development declines, tailings, and the process plant-and using permitted infrastructure within the concession - Cascabel is now firmly on a path to production in late 2028, hopefully sooner.
This optimised schedule brings forward first ore, strengthens our financing outlook, and highlights the value of the resource. We're moving faster-and we believe the project's economics will surpass earlier expectations. We will always tweak and optimise and if need be, pivot or add, but the critical focus now is delivering a project for the country and for our shareholders."
PROJECT EXECUTION PLAN
The optimised development plan for the Cascabel Project reflects SolGold's disciplined approach to project execution and capital allocation. With first production from the TAM open pit targeted for Q1 2028, and underground ore from the Alpala Sub-Level Cave scheduled by year-end 2028, the Company is focused on delivering near-term value while building toward full-scale, long-life production. The revised schedule incorporates critical infrastructure such as on-site tailings, process plant commissioning, and access development-executed within a tightly integrated timeline that prioritizes readiness, revenue, and risk mitigation.
Phase one of the G Mining Services ("GMS") scope of work is complete, culminating in the delivery of a Project Execution Plan ("PEP") for the Cascabel Project. The plan includes the following subsections: Scopes of Work for Major Areas, Engineering, Procurement, Construction, Health, Safety and Loss Prevention, Human Resources, and Risk and Opportunity Management plans. The PEP provides the foundation and definition for the Project to move forward into a feasibility study and the subsequent phases of development. The PEP has been reviewed and approved by Franco-Nevada (Barbados) Corporation and OR Royalties International Ltd. (formerly Osisko Bermuda Limited) (the "Streamers"), as one of the conditions of the second advance of US$33.3 million under the US$100 million initial deposit component of its US$750 million syndicated gold stream agreement.1
A key component of the PEP is the updated Project Schedule, which outlines a streamlined and accelerated path to production. By sequencing workstreams such as portal development, underground access, and surface infrastructure, the Company anticipates initiating ore processing in Q4 2028.
Optimised Project Schedule and Acceleration Highlights
· GMS has undertaken a rigorous schedule optimization process, identifying opportunities to accelerate the path to production while reducing risk.
· Through strategic sequencing and concurrent execution of critical activities-such as portal works, underground development, and surface infrastructure-the Company has compressed the development timeline without compromising safety or permitting integrity.
· Early works on the Alpala portal and decline system are expected to enable underground access by Q4 2027, several months ahead of the original plan.
· The construction timeline for the concentrator has been optimised from 24 to approximately 18-21 months by implementing modular build strategies and early procurement of long-lead items.
· An on-concession tailings facility will be fast-tracked to ensure tailings storage readiness aligns with mill commissioning-eliminating dependence on the longer-lead coastal infrastructure.
· Together, these optimizations are expected to bring forward the start of copper and gold production by several months, positioning Cascabel as a significant new contributor to global copper supply in 2028.
Optimised Development Milestones
Milestone / Key Activity | Optimised Schedule (Start - Finish or Milestone) |
Santa Cecilia Community Relocation - New town completed | Q2 2024 - Q2 2026 |
Amendment to Environmental License 1 (Concession Infrastructure) | End of Q4 2025 |
Alpala Portal Development - Surface preparation and access setup | Q1 2026 - Q3 2026 |
Alpala Access Declines - Underground access ready for SLC | Q4 2026 - Q4 2027 (complete ~Q4 2027 with parallel headings) |
Environmental License 4 (Alpala Mine) | End of Q2 2027 |
Environmental License 2 (TAM, TSF, Water) | Early Q2 2027 |
On-Concession Tailings Facility - Ready for operations | Early Q2 2027 - Early 2Q 2028 |
Tandayama Open Pit Development - First ore to stockpile | Q2 2027 - Q1 2028 (First ore ~Q4 2028) |
Process Plant & Infrastructure Phase 1 - First ore processed | Q2 2027 - Q3 2028 (Ore processed by ~Q4 2028) |
Alpala SLC Development - First Alpala underground ore | Q4 2027 - Q4 2028 (First ore ~Q4 2028) |
Environmental License 3 (Port & Concentrate Transport) | Q2 2028 |
Alpala Block Cave Development - First block cave ore | Q4 2028 - Q4 2031 (First ore ~late 2031) |

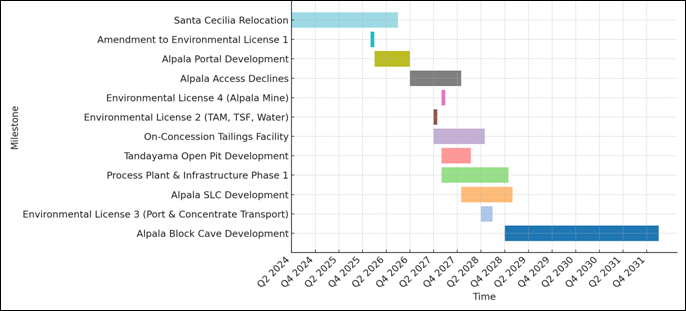

Figure 1: Accelerated Cascabel Project Timeline
Together, the optimizations are expected to bring forward the first ore from TAM to January 2028 and underground ore from Alpala SLC to late 2028. This represents a material acceleration of revenue generation and strengthens the Company's financing position.
EARLY WORKS PREPARATION
· Mobilisation Planning in Progress
SolGold and its project manager, G Mining Services, have completed site visits to plan for early works mobilisation in Q3 2025. These include permitted surface infrastructure.
· Expanded Early Works Scope
The broader scope of early works includes upgrading the access road, installing surface water management structures, and expanding camp capacity to support both early works construction teams and feasibility work. Contract negotiations are underway with key contractors for civil works.
· Advancing Project Readiness
While feasibility study activities continue, SolGold remains focused on advancing executable scopes that shorten the path to production. These early developments significantly de-risk critical path items and deliver Project momentum on the ground. These efforts are supported by engagement with debt, mezzanine, and strategic financing partners.
In parallel, the Company is also prioritizing land acquisition, permitting activities, and the relocation of the Santa Cecilia community-each of which is critical to advancing the Project.
TAILINGS AND PERMITTING
These early construction scopes have been sequenced to align with mill commissioning in Q4 2028, ensuring no delays from tailings readiness.
· Onsite TSF Solutions Advance
Independent geotechnical assessments by Knight Piésold Pty Ltd for the Cachaco and Parambas tailings storage facilities ("TSFs") confirmed the absence of fatal flaws, supporting designs that accommodate tailings for approximately the first ten years of operations. The sites are located entirely within the Cascabel concession and feature zoned earth and rockfill embankments, as well as diversion channels, to manage surface water.
· Permitting Advantages
The TSF locations within the mining concession are expected to streamline the permitting process. Stripping of soft foundation materials and installation of basal drainage systems are already factored into the design. Additional drilling will be undertaken in parallel to finalize geotechnical and hydrogeological data for the feasibility study and to refine designs.
ENVIRONMENTAL IMPACT ASSESSMENT UNDERWAY
Work continues on the Environmental Impact Assessment ("EIA") to support full construction approvals. SolGold is leveraging lessons learned from the exploitation agreement process and actively engaging with local and national stakeholders to ensure alignment with regulatory expectations and community needs. The collection of required baseline data, a major contributor to the EIA and permitting process, is ongoing.
EXPLORATION ("EXPLORECO") NEW COMPANY STRATEGY
Multiple parties have recently visited SolGold's regional exploration assets, reflecting continued strong interest from third parties. SolGold plans to launch a standalone exploration vehicle focused on early-stage copper-gold discoveries in Southern Ecuador.
The portfolio includes the highly prospective Porvenir project, as well as additional high-priority concessions situated in a district that hosts two producing mines: Fruta del Norte and Mirador. The southern portfolio provides strong peer comparisons and valuation benchmarks, particularly for an eventual listing on either the Australian or Canadian market.
SolGold is working closely with brokers and potential cornerstone investors to evaluate transaction structures and capital pathways. A more detailed update is expected in the coming week(s).

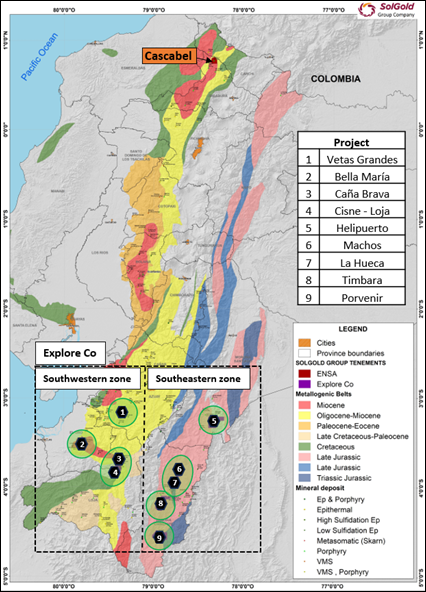

Figure 2: ExploreCo Planned Portfolio

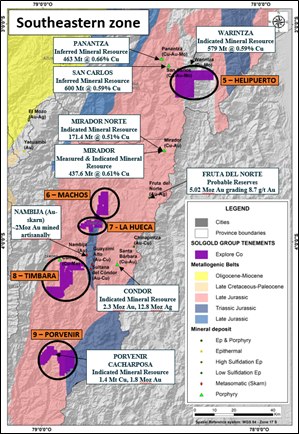

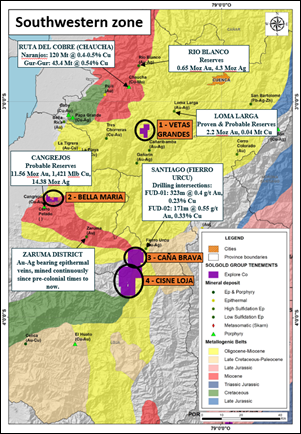

Figures 3 & 4: Planned ExploreCo Southwest and Southeast Zone Property Maps
TANDAYAMA-AMERICA DRILLING

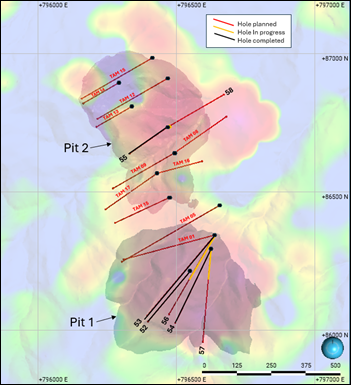

Diamond drilling is actively progressing with three rigs at the TAM deposit, targeting near-surface zones that may support a phased production strategy. Samples have been shipped for assay, with initial assays showing materially improved grades and widths. When the full drill program is completed and all assays are received, the Company expects to gain a more comprehensive understanding of the potential of this orebody, in terms of scale, quality, mining method, and place in the overall Cascabel mine plan.
Figure 2: Tandayama Ameríca Drilling Program
